How HVAC Subs Bid and Bill Commercial Work

By Wyatt Cooper · Published · 7 min read

Key takeaways

  • Equipment drives an HVAC job: its price, its lead time and its submittal approval date belong in the bid, with how long the quote holds.
  • Clarify controls, testing and balancing, crane picks, roof curbs and electrical connections, the edges where HVAC scope is most often disputed.
  • Bill equipment on its own material line, so a delivered unit can be billed as stored when the contract allows, including off-site storage only where it is authorized.
  • In the example below, a period with stored rooftop units and ductwork progress bills $249,520, with $24,952.00 retained at 10%.

HVAC subcontractors bid commercial work from the mechanical drawings and specifications with equipment quotes, a ductwork and piping takeoff, and labor by system, stating equipment lead times, how long the quote holds, and clarifications for controls, testing and balancing, crane picks and electrical connections. They bill monthly against a schedule of values with equipment material separate from setting labor, so delivered equipment can be billed as stored material where the contract allows it.

What drives an HVAC bid

On most commercial jobs the equipment (rooftop units, air handlers, chillers, boilers, split and VRF systems, exhaust fans) is the biggest single cost and the longest lead. The rest of the scope is sheet-metal ductwork, hydronic and refrigerant piping, insulation, grilles and diffusers, controls, startup, and testing, adjusting and balancing. The Mechanical Contractors Association of America represents contractors in mechanical, plumbing, HVAC, service and industrial piping work (MCAA), and the Plumbing-Heating-Cooling Contractors Association serves the plumbing and HVACR industry (PHCC).

Get equipment quotes in writing with the lead time from approved submittals, and say in your bid how long your equipment pricing holds and that the schedule depends on submittal approval and release by a date. There is no standard lead time: ask the supplier each time and write the answer down.

Clarifications that protect an HVAC bid

HVAC scope edges to state in every commercial bid
ItemThe questionState in the bid
ControlsIn your scope, a controls subcontractor's, or owner-direct?Included as specified, by your controls sub, or excluded
Testing, adjusting and balancingOften owner-held or a separate contractIncluded or excluded, and who corrects deficiencies
Crane and riggingWho provides the crane and the pick plan?Included, with how many picks
Roof curbs and openingsWho furnishes curbs, frames openings and flashes them?You furnish curbs; framing and roofing by others, or as priced
Electrical connectionsWho wires units, starters and disconnects?Power wiring by the electrical trade; control wiring as listed
CommissioningIs there a commissioning agent, and how many site visits?Support for the stated number of visits
Temporary heat and coolingWill the permanent equipment run during construction?Excluded, or the conditions and filters you include

A schedule of values with equipment broken out

A fictional $918,600 HVAC schedule of values
LineDescriptionScheduled value
1Mobilization and submittals$22,000
2Rooftop units, material$214,000
3Equipment set and connect$41,500
4Ductwork, fabricate and install$236,800
5HVAC piping$128,300
6Controls$96,400
7Grilles, registers and diffusers$34,900
8Insulation$52,700
9Startup$14,500
10Testing, adjusting and balancing$27,500
11Exhaust fans and split systems$38,000
12Closeout documents, O&M and training$12,000
Total$918,600

Ductwork is the largest line; split it by floor or zone on a bigger job so it bills as it is hung. Keep startup, balancing and closeout as their own lines so the last payments are tied to the work the owner needs to accept the system.

Billing stored equipment

Equipment often arrives before the roof is ready, or waits at the supplier for the crane date. The contract decides whether you can bill it. On federal fixed-price work, material delivered to the site may be counted, and material stored elsewhere only if the contract specifically authorizes it and you furnish satisfactory evidence that you have title to it and it will be used on the job (FAR 52.232-5). Private contracts often ask for a bill of sale, an insurance certificate naming the stored goods, photos and, for off-site storage, the storage location and access. Stored material carries retainage; see how to calculate retainage.

Worked example: rooftop units stored off site

The fictional "Brightwater Mechanical" holds the $918,600 subcontract above with 10% retainage, and the subcontract allows off-site stored material with a bill of sale and insurance. In period 5 the rooftop units are complete and held at the supplier's yard for the crane date, and ductwork moves from 25% to 40%.

Brightwater Mechanical, period 5, the lines that moved (fictional)
LinePreviousThis periodStoredTo date
2. Rooftop units, material ($214,000)$0$0$214,000$214,000 (100%)
4. Ductwork ($236,800)$59,200 (25%)$35,520 (15%)$0$94,720 (40%)
Total of these lines$59,200$35,520$214,000$308,720

This period bills $35,520 of work plus $214,000 stored = $249,520. Retainage at 10% is $24,952.00, so these lines add $224,568.00 to the payment due. Checks: 25% of $236,800 is $59,200 and 15% is $35,520, together $94,720, which is 40%; $59,200 + $249,520 = $308,720. When the units are set, the setting labor bills on line 3, not on line 2 again.

Brightwater Mechanical, stored equipment, period 5: rooftop units (line 2)

Equipment
Rooftop units RTU-1 to RTU-4, per approved submittal
Where stored
The supplier's yard, tagged for this project
Amount billed as stored
$214,000.00, the supplier's invoice
Proof of title
Bill of sale from the supplier to Brightwater Mechanical
Insurance
Certificate covering the units in storage and in transit
Attached
Invoice, bill of sale, dated photos of the tagged units
The backup a fictional sub sends with off-site stored equipment, where the subcontract asks for it

HVAC closeout documents

  • The testing, adjusting and balancing report.
  • Startup reports for each piece of equipment, often on the manufacturer's forms.
  • Controls as-builts, sequences of operation and points lists.
  • O&M manuals, equipment warranties and owner training records.
  • As-built ductwork and piping drawings, the final lien waiver and the retainage release request.

For the monthly form, see how to fill out a pay application as a subcontractor; the same phased approach for the plumbing trade is in how plumbing subs bid and bill.

How it works in Conflo

On a GC's job in Conflo, long-lead equipment is tracked in Procurement: each item with its CSI division, supplier, responsible company, submittal reference, lead time and need-on-site date, from which Conflo works out the latest date to order it, and flags items that are late to order or expected after they are needed. A sub sees the items its company is responsible for, can add its own, moves them from ordered to shipped to delivered with their dates, and can change an item's details unless the GC has locked it.

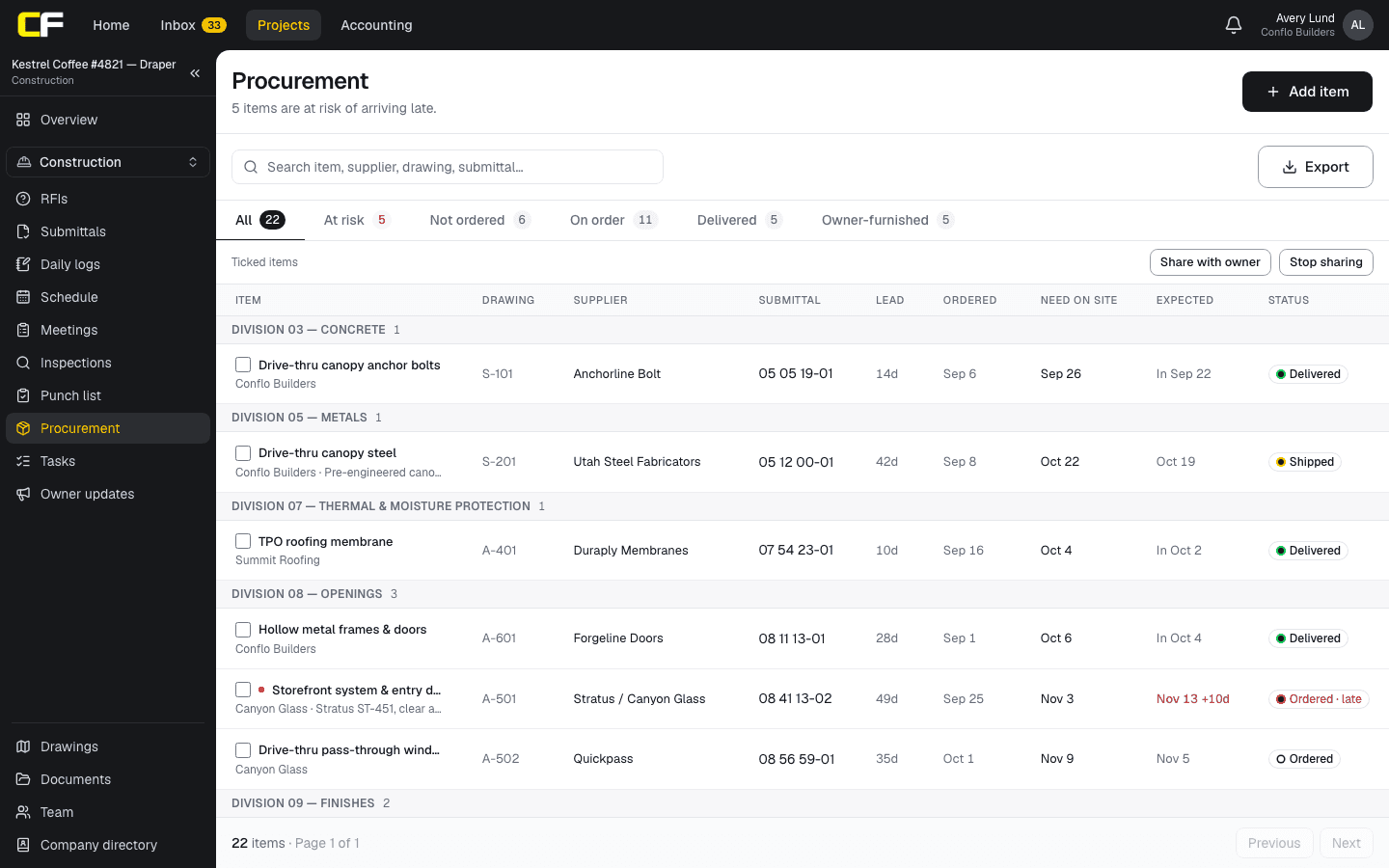

The Procurement log in Conflo: long-lead items by CSI division with the drawing, supplier, submittal, lead time, order date, need-on-site and expected dates, and status, with late items flagged.
The GC's Procurement log in Conflo: long-lead items by CSI division with lead time, order and need dates, and late items flagged.

The sub bids through Trade bids and bills in Pay apps, entering percent complete this period and materials stored per line; stored material billed once carries into previous billing on the next pay app. Not built today: a bill of sale or storage location attached to a stored line, and a separate retainage rate for stored materials.

The bottom line

HVAC bids are equipment bids with a lot of labor attached. Put equipment price, lead time and how long the quote holds in writing, clarify controls and balancing, and keep equipment on its own material lines so it can be billed when it is delivered.

Before the next bid, ask your equipment supplier for lead times from submittal approval, not from order, and write them into your proposal.

Join the Conflo waitlist

Sources

  1. Who We Are — Mechanical Contractors Association of America. Read October 16, 2026.
  2. Plumbing-Heating-Cooling Contractors Association — PHCC. Read October 16, 2026.
  3. FAR 52.232-5, Payments under Fixed-Price Construction Contracts — Acquisition.gov, U.S. General Services Administration. Read October 16, 2026.

Questions

How do you bid commercial HVAC work?

Get written equipment quotes with lead times, take off ductwork, piping and insulation, price labor by system, and state clarifications for controls, testing and balancing, crane picks, roof curbs and electrical connections, plus how long your equipment pricing holds.

Can an HVAC sub bill for equipment before it is installed?

Usually as stored material, if the contract allows it. Off-site storage normally needs specific authorization and proof of title and insurance; on federal fixed-price work it is allowed only where the contract authorizes it.

Is testing and balancing part of the HVAC subcontract?

Sometimes. It is often held by the owner or let as a separate contract so the balancer is independent. Say in your bid whether it is included and who corrects deficiencies.

Why split equipment material from setting labor on the schedule of values?

So a delivered unit can be billed as stored material before it is set, and the setting labor billed when it happens, without billing the same dollars twice.
