Change Order vs Construction Change Directive

By Wyatt Cooper · Published · 4 min read

Key takeaways

  • A change order records agreement: on AIA forms, the owner, contractor and architect sign it, and it settles the change in price and time.
  • A construction change directive orders the contractor to proceed before the price or time is agreed; the adjustment is settled later, often by cost plus a fee.
  • Federal contracts use the words differently: there, a change order is the government's one-sided order, and the agreed price is a bilateral modification.

A change order is a signed agreement between owner and contractor (on AIA forms, the architect too) that settles a change in the work and its price and time. A construction change directive is the owner's written order, usually prepared by the architect, to proceed with a change before price or time is agreed.

Agreed now, or settled later

AIA Contract Documents describes its change order form, G701, as being for changes agreed to by the owner, contractor and architect, and says executing it indicates agreement on all terms of the change, including the contract sum and time (AIA, G701 summary). Its construction change directive, G714, is for changes where the owner and contractor have not agreed on the price or time; on receiving one, the contractor must promptly proceed with the change (AIA, G714 instructions).

A directive keeps the job moving when waiting for a price would delay it. G714 offers three ways to set the adjustment: a lump sum, unit prices, or cost plus the contractor's fee. The contractor signs if it agrees with the proposed adjustment; if not, it tells the architect, and the method in A201 §7.3.4 applies. Once price and time are agreed, a change order records them.

Change order and construction change directive side by side
Change orderConstruction change directive
Price and timeAgreed and statedNot yet agreed; a method is proposed
Who signsOwner and contractor (AIA: and architect)Architect and owner; the contractor signs only if it agrees with the proposed adjustment
The workProceeds as agreedProceeds now, priced later
Federal wordsBilateral modification (supplemental agreement)Change order, signed only by the contracting officer

The federal meaning is the other way round

In the Federal Acquisition Regulation, a change order is a written order signed by the contracting officer directing a change the changes clause allows without the contractor's consent (FAR 2.101). It is a unilateral modification; the negotiated price adjustment that follows is a bilateral modification, signed by both, also called a supplemental agreement (FAR 43.103). Meanwhile the contractor keeps working: the disputes clause requires it to proceed diligently pending resolution of a claim (FAR 52.233-1).

Example

On a fictional office job, the owner needs added firestopping at new penetrations before an inspection next week, and the GC's price is still under review. The architect prepares a directive on a cost-plus basis with a 10% fee, and the owner signs it. The GC proceeds and tracks the cost: $18,240.00. Fee: 10% × $18,240.00 = $1,824.00. Once both sides check the records, a change order for $20,064.00 and zero days closes it.

Pricing the change order itself is the same either way: how to price a change order and the change order pricing calculator. An owner deciding whether to sign either one can follow how to review a change order as an owner.

How it works in Conflo

Conflo's change orders are the agreed kind: priced lines, the GC's markup, schedule days, GC review, then owner approval, which executes the change. There is no separate construction change directive record today; a directive's paper can be attached to a change order's files while its price is worked out.

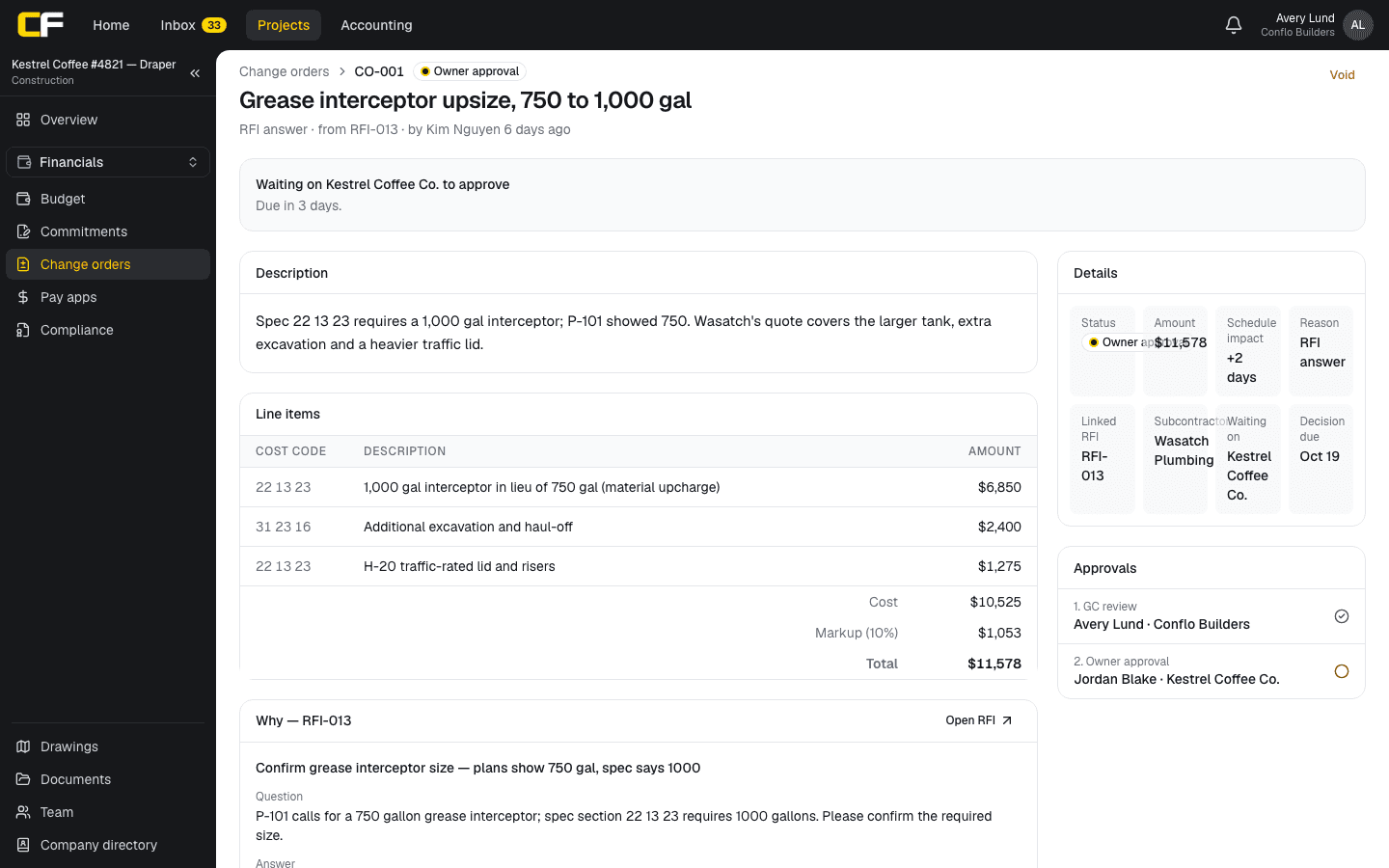

A change order waiting on owner approval in Conflo: a grease interceptor upsize from an RFI answer, three cost-coded lines with a 10% markup on the total, two days of schedule impact, the GC review and owner approval steps, and the RFI it came from.
A change order in Conflo waiting on owner approval, with its priced lines, markup and schedule days.

The bottom line

A change order is agreement on the change, its price and time; a construction change directive is an order to proceed first and settle the price later.

Either way, track the cost from day one.

See how change orders work in Conflo

Sources

  1. Summary: G701–2017, Change Order — AIA Contract Documents. Read October 16, 2026.
  2. Instructions: G714–2017, Construction Change Directive — AIA Contract Documents. Read October 16, 2026.
  3. FAR 2.101, Definitions — Acquisition.gov, U.S. General Services Administration. Read October 16, 2026.
  4. FAR 43.103, Types of contract modifications — Acquisition.gov, U.S. General Services Administration. Read October 16, 2026.
  5. FAR 52.233-1, Disputes — Acquisition.gov, U.S. General Services Administration. Read October 16, 2026.

Questions

Does a contractor have to follow a construction change directive?

Under AIA's G714, yes: on receipt, the contractor must promptly proceed with the change, and the price and time are settled afterward. Other contracts set their own rules. Check yours.

How is a construction change directive priced?

By the method it states: a lump sum, unit prices, or the cost of the work plus the contractor's fee. Once the parties agree on the amount and days, a change order records them.
