What Is a Look-Ahead Schedule?

By Wyatt Cooper · Published · 3 min read

Key takeaways

  • A look-ahead is a short-range slice of the master schedule, commonly three weeks, rebuilt every week with the trades.
  • It uses the master schedule's activity names and IDs, so the field plan and the contract schedule stay the same plan at two levels of detail.
  • Its job is to clear the way: materials, submittals, inspections, crews and open RFIs are checked before the work's start date, not on it.

A look-ahead schedule is a short-range schedule, usually covering the next two to six weeks, that breaks the master schedule's activities into the day-by-day work each crew will do. The superintendent updates it weekly with the subcontractors, so materials, inspections, manpower and open questions are lined up before the work starts.

Where the look-ahead comes from

Owners write it into their specifications. The City of Los Angeles has the contractor produce, each week, a "Three-week Progress Schedule listing the activities completed and in progress for the previous week and the activities scheduled for the next two weeks" (so its look-ahead part is two weeks), with activity descriptions and IDs "consistent with the project's baseline construction schedule" (LA Bureau of Engineering, 18.1). The federal schedule specification reviews "the upcoming planned activities via a three week lookahead" at the weekly meeting with the government (UFGS 01 32 01.00 10, 3.7).

So a look-ahead is not a second schedule. It is the master schedule's next few weeks, broken into crew-sized pieces and checked for anything that would stop the work. It is usually reviewed at the OAC meeting and the subcontractor coordination meeting. The method, step by step, is in how to build a three-week look-ahead, and there is a free three-week look-ahead template.

Example

Part of a three-week look-ahead (fictional project)
Master activityLook-ahead workCrewWeek 1Week 2Week 3Needs before start
A2100 Level 2 framingInterior walls, grids C–FFraming sub, 8Mon–FriMon–WedTrack and studs on site
A2140 Level 2 rough-inElectrical rough-inElectrician, 4Wed–FriMon–FriFraming complete in grids C–F
A2200 Level 2 inspectionCover inspectionCity inspectorThuInspection requested 48 hrs ahead

The last column is the point: each row names what must be true before the crew can start, so it gets checked a week or two early. When a row slips, the critical path tells you whether the finish date moves.

How it works in Conflo

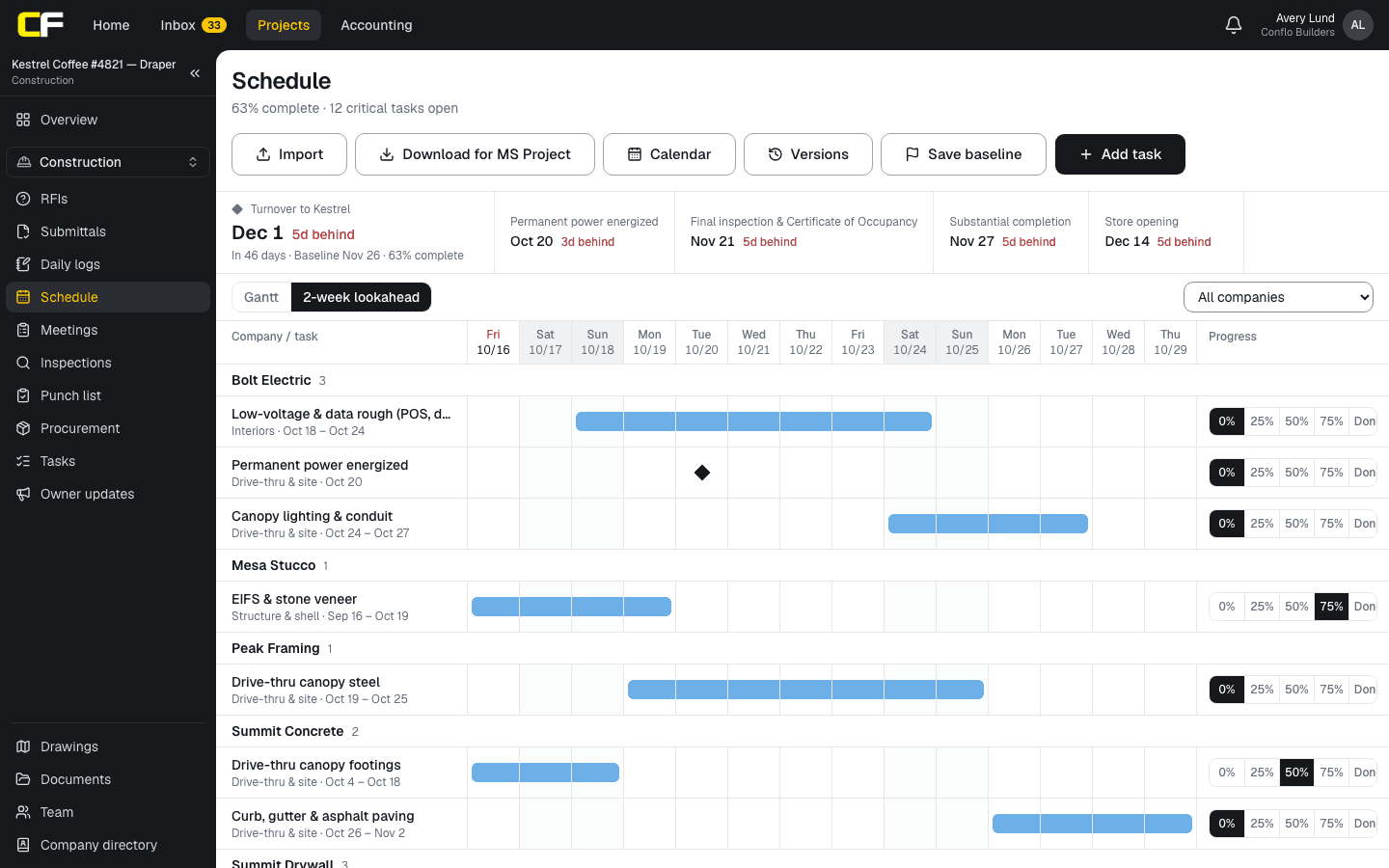

Conflo's schedule has a two-week lookahead: the next 14 days of work, grouped by the company responsible, with progress and critical tasks marked and a filter to one company.

The 2-week lookahead in Conflo: the next 14 days as columns from today, weekends shaded, with each task grouped under the company doing it (an electrician, a stucco sub, a framer, a concrete sub), a bar across the days it runs, a diamond for a milestone, and buttons to set each task's progress from 0% to done.
The 2-week lookahead in Conflo: the next 14 days, each task under the company doing it.

The bottom line

A look-ahead is the next few weeks of the master schedule, written at crew level and rebuilt every week.

Keep the master schedule's activity IDs, and use it to clear materials, submittals and inspections before each start date.
