How Do You Keep an RFI Log?

By Wyatt Cooper · Published · 7 min read

Key takeaways

  • The RFI log is one numbered list of every RFI on the job, showing who each one is waiting on, when it was sent, when the answer is due and how long it has been open.
  • Ball in court is the most useful column: it says whose move it is, so the weekly meeting can chase the right person.
  • Count days open in calendar days from the day the RFI was sent to the day it closed, or to today if it is still open; overdue means today is past the due date with no answer.
  • Mark cost and schedule impact on every line, so the log shows at a glance which open questions could become change orders or delays.

To keep an RFI log, list every RFI in one numbered sequence with its subject, who sent it, who it is waiting on, the date sent, the date the answer is due, the date answered and closed, its status, days open, and any cost or schedule impact. Update it the day anything changes, sort the open ones oldest first, flag the overdue ones, and review it at every weekly meeting.

What the log is for

An RFI form asks one question. The log answers a different one: across every question on the job, what is waiting on whom, and for how long? The form is covered in how to write an RFI, with a free RFI template. This post is the list that tracks them.

Public owners build the log into their procedures. The City of Los Angeles Bureau of Engineering's RFI procedure has RFIs "sequentially numbered starting with the number one" and tracked in the city's document control system. Its meetings procedure has the construction manager "establish the time limit for all unanswered RFIs" at the weekly meeting, and its minutes procedure attaches the updated RFI log to each week's minutes. Connecticut's construction administration manual tells its construction administrator to emphasize the RFI contract provisions at the preconstruction conference.

The columns of an RFI log

The columns of an RFI log and what each one tells you
ColumnWhat goes in itWhat it tells you
RFI numberOne project-wide sequence, never reusedThat nothing is missing from the sequence
SubjectThe element and the problem in a few wordsWhat it is, without opening it
FromThe company that raised it (a sub's RFI comes through the GC)Which trade is waiting
Ball in courtThe person or company who must act nextWho to chase
SentThe date it went to the person who answersWhere days open starts
DueThe date the answer is needed, per the contract or the RFIWhen it becomes overdue
Answered and closedThe date the answer came back, and the date the GC closed itWhether the answer has reached the field
StatusDraft, open, answered, closedWhere it is in its life
Days openCalendar days from sent to closed, or to todayHow long the question has cost
Cost and schedule impactNo, possible or yes, for eachWhich ones could become a change order or a delay

A filled-in RFI log, with days open counted

Here are the five most recent RFIs on a made-up job, as of Tuesday, April 7, the morning of the OAC meeting. Days open count calendar days from the sent date: RFI 019 was sent March 27, so March 28 to 31 is 4 days and April 1 to 7 is 7 more, 11 in all. Its answer was due April 3, so on April 7 it is 4 days overdue.

An RFI log on a fictional job, as of April 7. Every subject, name and date is made up.
RFISubjectBall in courtSentDueAnsweredStatusDays openCost / schedule
019Roof drain sizing at the east roofMEP engineerMar 27Apr 3—Open, overdue11Possible / yes
020Stair 2 handrail extension at the landingArchitectMar 30Apr 9—Open8No / no
021Conduit routing through shear wall line 4—Apr 1Apr 8Apr 3Closed Apr 43No / no
022Storefront sill height at the finish floorGC (to close)Apr 2Apr 9Apr 6Answered5No / possible
023IT room conduit sizesOwnerApr 3Apr 10—Open4Possible / no

Check the arithmetic the same way for each line. RFI 020: March 31 is 1 day, plus April 1 to 7 is 8. RFI 021 closed on April 4, so it stopped counting there: April 2, 3 and 4 make 3. RFI 022 is answered but not closed, so it is still counting: April 3 to 7 is 5. RFI 023: April 4 to 7 is 4.

Read the log the way the meeting will. One RFI is overdue, and it is the one marked yes for schedule: it goes first. RFI 022 has an answer sitting with the GC; until it is closed and sent to the storefront sub, the answer hasn't reached the field. And two open RFIs say "possible" for cost, so the PM knows where change orders may come from.

Keeping it current

  1. 1GC project managerNumbers the RFI, logs it as sent, sets the due date
  2. 2Architect or engineerBall in court until the answer goes back
  3. 3GC project managerLogs the answer, sends it to the field and the trades
  4. 4GC project managerCloses it, and starts a change order if the answer adds cost or time
One RFI's life on the log
  • Update the log the day anything happens, not before the meeting.
  • Sort open RFIs oldest first, overdue at the top.
  • Move the ball when it moves. An RFI sent back to you for clarification is in your court again.
  • Don't close an RFI until the answer is in the field. The trades build from the answer, not from the log.
  • Send the log with the OAC meeting agenda, and attach it to the minutes.
  • Keep the log after the job. If a delay is disputed later, its dates show who was waiting on whom.

The design team's side of the log, turning answers around on time, is in how to respond to an RFI.

How it works in Conflo

In Conflo's RFI tool, the log is built from the RFIs themselves, so there is nothing to retype. Each row shows the RFI's number, subject, who it is waiting on, status, days open and due date, and an overdue RFI is marked as overdue. Tabs split the log into all, waiting on you, open, overdue, drafts and closed, and you can search it.

The log exports as a PDF of every RFI matching the tab and search: number, subject, who it is from, status, who it is waiting on, the sent, due, answered and closed dates, days open, and cost and schedule impact, with counts of open, overdue and closed RFIs.

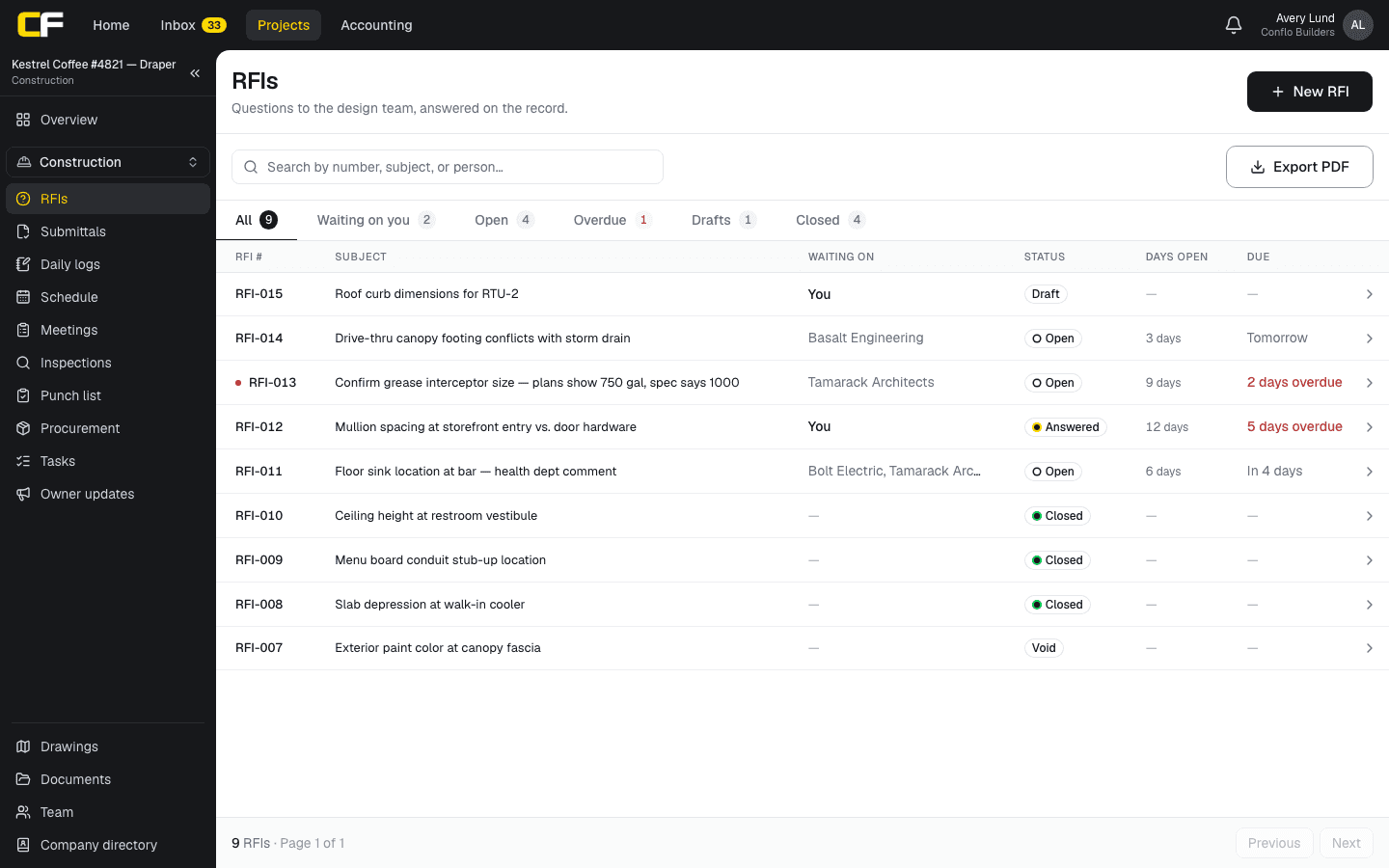

The RFI log in Conflo: each RFI's number, subject, who it is waiting on, status, days open and due date, with tabs for RFIs waiting on you, open, overdue, drafts and closed.
The RFI log in Conflo: each RFI's number, subject, who it is waiting on, status, days open and due date.

The bottom line

An RFI log is one numbered list with the columns that drive action: ball in court, sent, due, answered, days open and impact. Update it the day anything changes, put the overdue ones first, and review it at every weekly meeting.

If your log is a spreadsheet someone retypes before each meeting, build it from the RFIs instead.

See how RFIs work in Conflo
